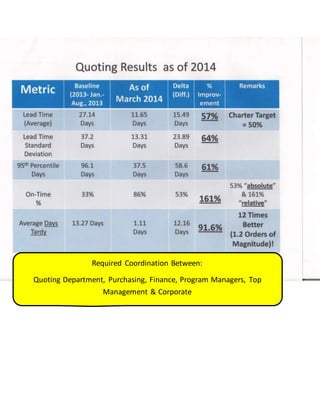

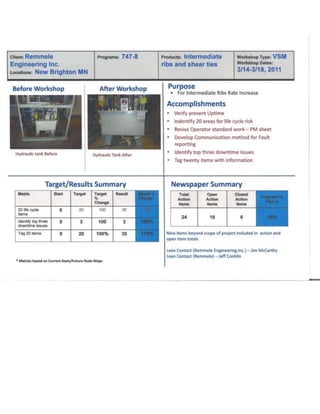

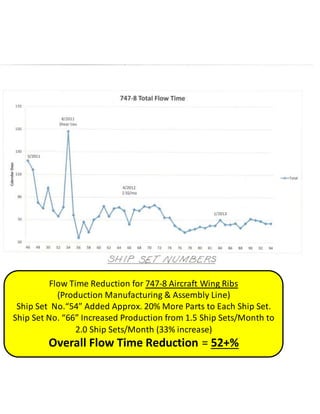

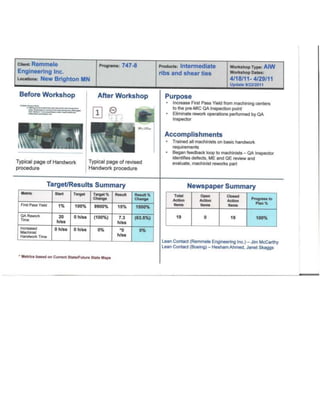

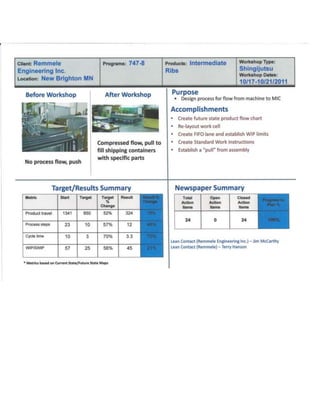

This document discusses coordination required between various departments for a project to reduce flow time for 747-8 aircraft wing ribs production. It achieved over a 50% reduction in overall flow time by adding approximately 20% more parts to each ship set for ship set 54 and increasing production from 1.5 to 2 ship sets per month, a 33% increase, for ship set 66.
